Oxfordshire Connect
We’re expanding Oxford station to enable an increase in train services.

The rail infrastructure in the Oxford Station area is near full capacity. It currently can’t support the start of East West Rail services. Through Oxfordshire Connect, the station is being expanded and the area upgraded, benefiting passengers and residents alike.
Jump to
Our plans
July 2026 update
In July 2026, it was confirmed that Botley Road will reopen to traffic on Sunday 20 September.
The reopening of Botley Road had previously been planned for the end of August, following a programme review and revision in January 2025 that prioritised reopening the road to traffic.
However, during excavation work relating to drainage for the new road layout, three minor gas leaks were identified on part of the gas network owned by SGN.
In the interests of safety, and to avoid disruptive and unplanned repair work in the future, Network Rail agreed to accommodate SGN’s essential work to replace a section of the gas network beneath Botley Road, alongside the completion of the remaining construction work.
Network Rail and SGN working closely to integrate their programmes. The two organisations will continue to work collaboratively to complete the remaining works as quickly and safely as possible.

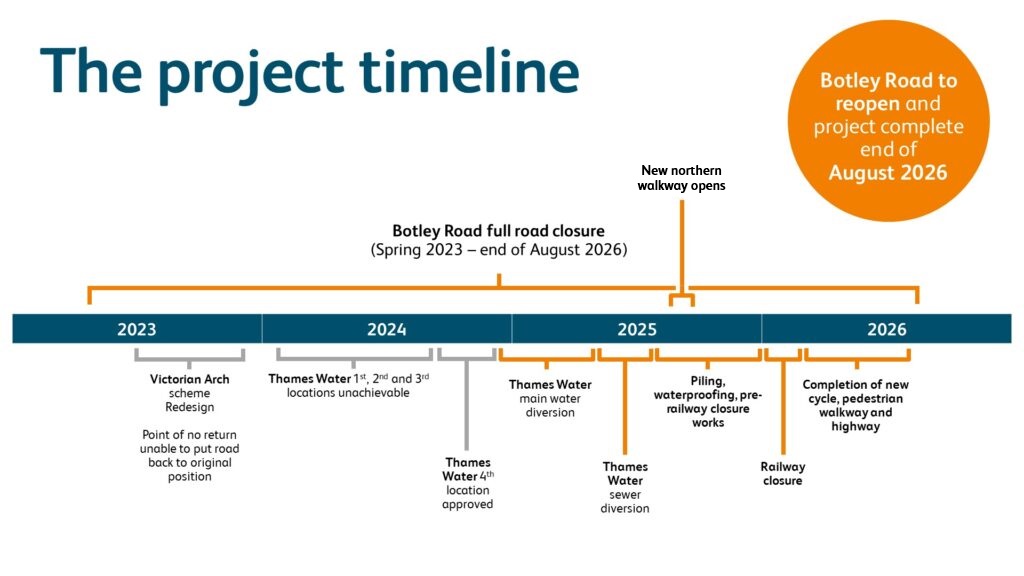

In January 2025 we launched a new programme, focused around getting an improved walkway/cycleway created by summer 2025 and Botley Road reopened in summer 2026.

Our work to upgrade Oxford Station, expanding the railway infrastructure in the area and improving the local road network will bring:
- A bigger, better station for everyone
- More services with East West Rail
- Additional rail capacity for the future
- An improved and safer road layout
These upgrades will boost the economy in the long term with more rail services to support businesses, residents and visitors to the city. By extending the rail network across Oxford and Oxfordshire, they will also drive sustainability, improving access to fast, sustainable passenger and freight transport.
Frequently Asked Questions
Stakeholder update sessions
|
Date
|
Time
|
Venue
|
|---|---|---|
|
Wednesday 14 October 2026 |
Tea & cake, next steps |
The Kings Centre, Osney Mead, Oxford OX2 0ES |
|
November 2026 |
Meeting date and venue TBC |
|
|
December 2026 |
Meeting date and venue TBC |
Botley Flyer
During the closure of Botley Road, the Botley Flyer has provided an accessible, free minibus service between west Oxford and the city centre. The final Botley Flyer services will run on Saturday 19 September. From 20 September, it will be replaced by commercial bus services.
Monday – Saturday
- West Oxford Community Centre pick-up 10am, 12pm, 3pm
- Magenta self-storage bus stop pick-up 10.05am, 12.05pm, 3.05pm
- Elms Parade West Way bus stop pick-up 10.10am, 12.10pm, 3.10pm
City Centre return journeys starting at 11am, 1pm, 4pm
Sunday
- West Oxford Community Centre pick-up 9.30am
- Magenta self-storage bus stop pick-up 9.35am
- Elms Parade West Way bus stop pick-up 9.40am
City Centre return journeys starting at 12.30pm

The Botley Flyer provides a free service to help people get into the city centre. On bank holidays, the Botley Flyer runs on the Sunday timetable.
For all journeys, the driver will make arrangements with passengers for return journeys before dropping them off.
Call 01865 768 329 to book a wheelchair space. Or email OxfordFeedback@networkrail.co.uk for more information
