Dolphin Junction upgrade
We’re improving an important junction in Berkshire for better passenger journeys
Over an eight-month period we are replacing and enhancing the eastern side of Dolphin Junction, between Slough and Langley stations, to improve reliability for journeys through the Thames Valley into London. It follows an upgrade on the western side of the junction during Christmas 2025.

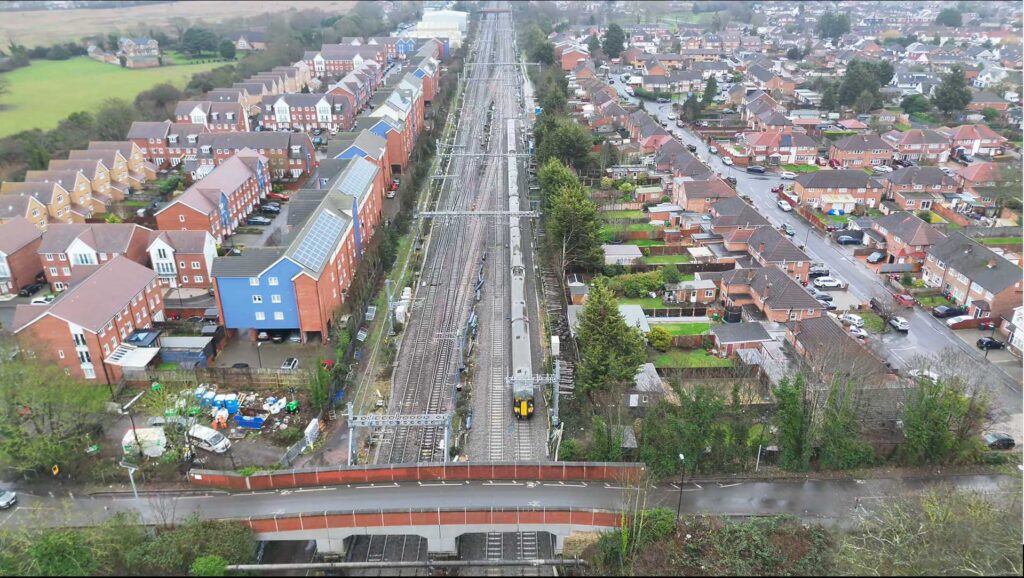

Work on the eastern side of the junction began in June 2026, with the installation of new overhead electrification equipment. With a new track layout being installed, the position of existing masts and gantries that carry the overhead power lines needed to change. State of the art points operating equipment will be installed, updating outdated systems for more reliable journeys.
The bulk of the track work takes place during the autumn and over the Christmas to New Year period.
Project in numbers
- £27.8m invested in renewing and enhancing Dolphin Junction.
- Over 400 passenger trains pass through Dolphin Junction every day
- 123 million tonnes of freight are carried over the junction each year
- 88 pre-constructed track panels will be fitted together like a huge jigsaw, making up the new track layout on the eastern side of the junction.
- Nine new structures for overhead power lines are being installed including four gantries.
- One kilometre of new wire for overhead power lines is being installed onto the new gantries and masts alongside the existing wire through the junction.
- State of the art points operating equipment is being installed and two signals are being relocated, along with lineside location cabinets and other signalling components.
Project timeline
June / July 2026: Piling foundations and installing new masts and components for updated overhead electrification equipment.
August / September 2026: Vegetation management, lineside signalling equipment installation, delivery of rail and specialist pre-constructed track panels.
October / November 2026: Remove scrap and redundant electrification equipment, delivery of pre-constructed track panels. Installation of new track (during the 28/29 November weekend closure of the railway).
December 2026 / January 2027: Ongoing track renewal work and preparation for installation of the new points during the 10-day closure of the railway over the Christmas and New Year period.
Travel information
Changes to journeys between Reading, Heathrow and London Paddington:
- 28/29 November 2026
- 27 December 2026 – 3 January 2027
We’ll get you where you need to go between Reading, Heathrow and London Paddington this November and December as we upgrade Dolphin Junction in Slough for more reliable journeys.
Every day more than 400 trains and 100,000 passengers pass through the junction.
Through the upgrades, there will be journey options via London Euston, London Marylebone, London Waterloo or TfL
Please plan ahead, allow extra time for your journey, and check before you travel:
