The Portishead Line

We’re restoring the Portishead Line from Bristol to Portishead.

Digital newsletter

Sign up for our digital newsletter to get up-to-date information delivered to your inbox. Simply complete the form below and the latest updates on our work will be sent to you.

The Portishead Line

The branch line was closed in 1964 but when reopened in 2028, it will reconnect more than 50,000 people to the railway. The project is funded by Government, the West of England Combined Authority and North Somerset Council and is being delivered by Network Rail.

The restored railway will provide an hourly direct train from Portishead to Bristol Temple Meads in around 25 minutes. The route runs along one of the most scenic stretches of railway in the country, under the Clifton Suspension Bridge and through the Avon Gorge.

New stations will be built at Portishead and Pill. Three miles of new track will be laid from Portishead to join the existing railway at Pill, which is currently used only for freight to Royal Portbury Dock. An additional line will be added through Pill to allow trains to pass each other. The whole railway from Portishead to Parson Street will be upgraded and signals and communication masts will be installed.

What work is taking place?

Portishead

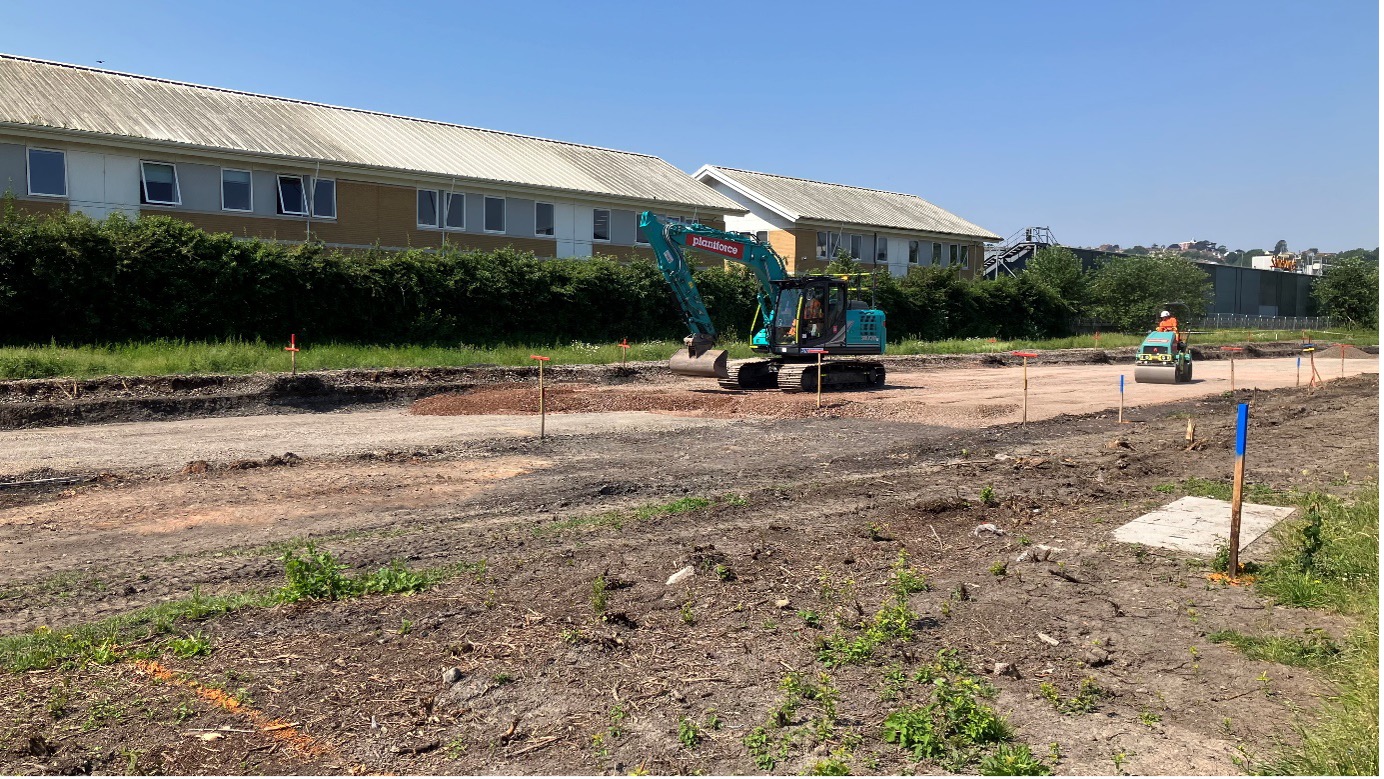

We’re building a new Quays Avenue and roundabout to make space for the new station. A new road layout is in place on Quays Avenue but two-way traffic remains. A one-way system is in place on Harbour Road until autumn 2026, with traffic only able to travel towards the roundabout from Newfoundland Way.

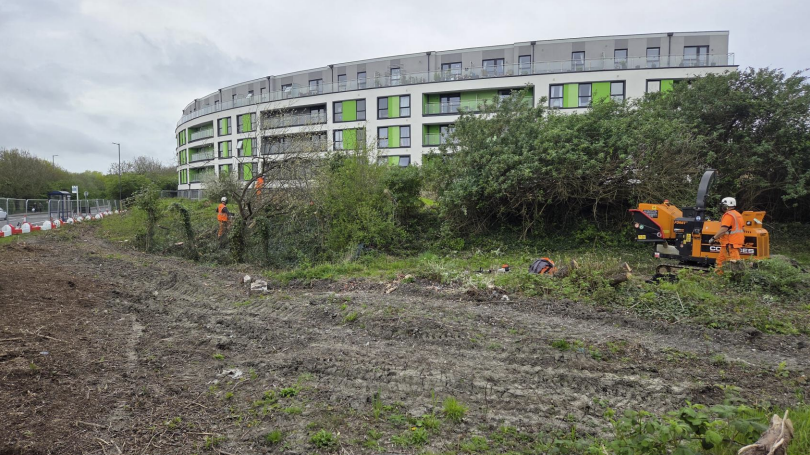

We’re removing the old rail between Portishead and Pill and preparing the area for new track to be laid in 2027. We’re also setting up our site compound off the A369 Portbury Hundred. A temporary speed limit is in place for safely.

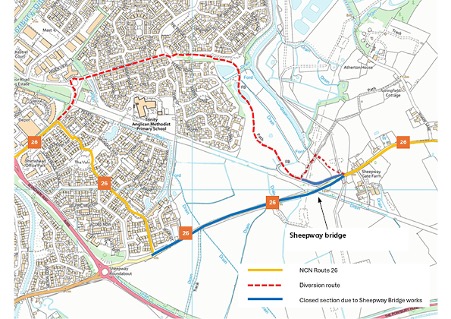

Work has also begun to strengthen Sheepway bridge. The bridge is closed to all traffic and pedestrians until autumn 2026. The NCN26 is diverted via Quays Avenue, Phoenix Way and the Ecology Park.

Buses will not run along Sheepway and bus stops at Conference Close, Portishead Ecology Park and Shipway Farm are suspended during the bridge closure. A shuttle bus will operate between Elm Tree Farm, Station Road, a temporary stop on Wyndham Way near the roundabout with Sheepway and Sainsbury’s in Portishead. The shuttle bus runs every 20 minutes from 8am to 5pm, Monday to Friday.

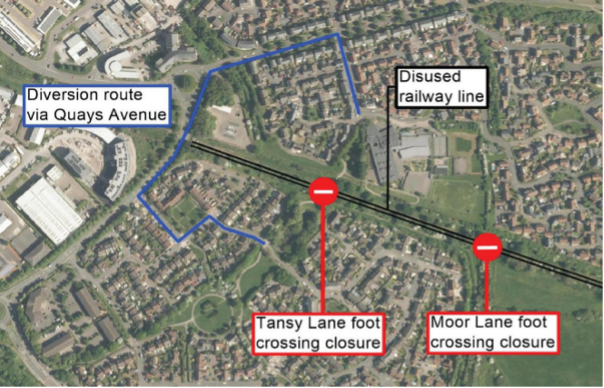

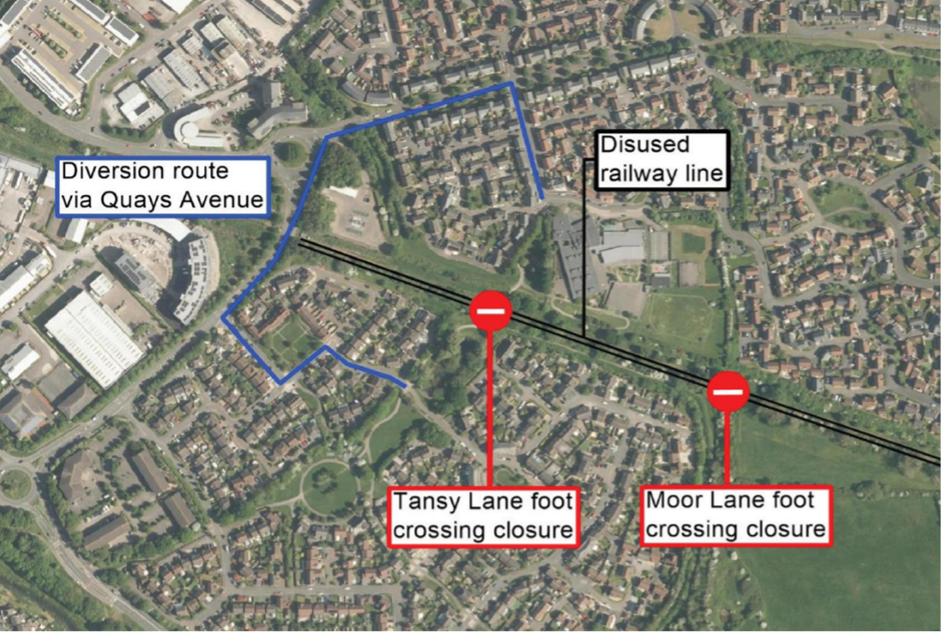

Map to show diversion of NCN26 during Sheepway bridge closure for pedestrians and cyclists

Pill

The next stage of construction is underway in Pill. The cuttings alongside the railway are being excavated to create space for the new station platform. Once cut back, the soil will be reinforced with over 2,000 steel rods, sprayed concrete and mesh. The work will be completed by the end of 2026.

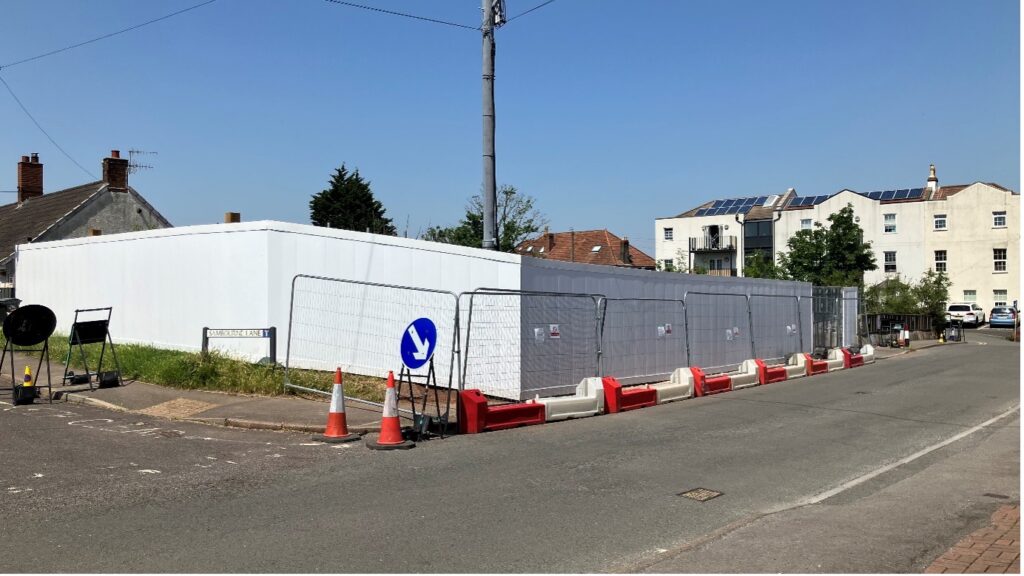

The main site compound at Lodway Farm, opposite the Hammer and Spanner sculpture, is being developed and will be in full use by November.

Drainage is being upgraded on Underbanks with the road closed from 20 August to 29 October. Four-way lights are also in place on Lodway while improvements are made to the bus stop, road and pavements.

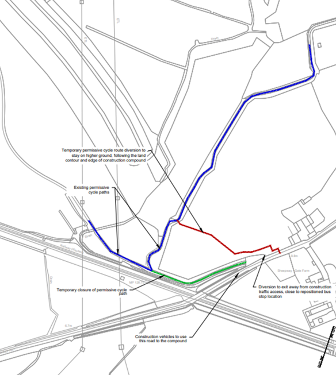

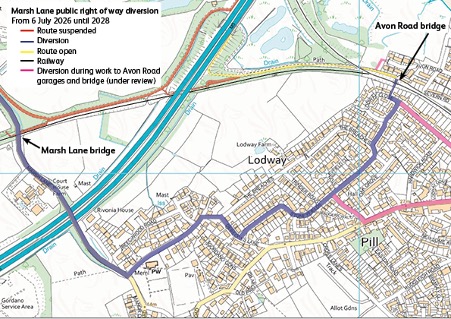

Map to show public right of way diversion from Marsh Lane bridge to Pill until early 2028.

Ecology

Extensive work has taken place to ensure species living near the railway are protected while the work takes place, such as toads, reptiles, badgers and bats. Rare whitebeam trees have also been grown and planted in Leigh Woods in the Avon Gorge. All the work has been completed in conjunction with Natural England.

Why is the work needed?

The Portishead Line is phase one of the wider Metro West project to improve rail links in Bristol and surrounding areas, improving connectivity and enhancing the local economy. Phase two will include new stations on a rail line to Henbury.

In total Metro West aims to provide seven new stations and five new or enhanced rail links by 2028.

New stations:

  • Portway Park and Ride – opened August 2023
  • Ashley Down – opened September 2024
  • Charfield – construction in progress
  • North Filton/Brabazon – construction in progress
  • Portishead
  • Pill
  • Henbury
